Good Expediter = Smooth Sailing @ DOB

We got a VERY good call today… After a lot of frustration earlier, our PAA was approved! There’s still some paperwork that has to be processed before it’s all finalized in the system, but it’s been a world of difference dealing with our new expediter / code reviewer – Levi Reznicek of William Vitacco Associates (lreznicek @ vitacco . com). He knows his stuff, and he and his company are trusted by the plan examiners. That makes all the difference. They know how to book appointments closer together, the plan examiners don’t mind if they stop by for quick things without an appointment, etc. It’s a completely different experience working with them. DOB used to scare me – it seemed so arbitrary. But now I feel like we have someone on board who can truly expedite things.

At the end of the day the solution to our construction classification problem was to revert back to the previous building classification, which was a 1938 classification. That means we’re now being reviewed under 1938 code. 1938 code requires 5 story buildings to have a 3 hour separation between the basement and upper floors (e.g. a thick concrete floor). But we got around that by being fully sprinklered (sprinklers didn’t exist in 1938).

The one thing we’ll have to change is that the rear deck has to be fully non-combustible. There was some question as to whether Trex (the plastic wood) was non-combustible. Some of it has a Class A fire rating, but it’s not quite “non-combustible”. So we’ll have to go with an all-steel deck.

I should mention that our architect has worked with a lot of big expediting firms. The reason why he had us go with William Vitacco is because to him they seemed like the most responsive and proactive of the big firms. And that impression was confirmed as we worked with Levi to prep for today’s meeting.

We’re using Levi / William Vitacco for our C of O process – so hopefully that will be smooth sailing as well…

Yesterday’s Big Purchase – Balusters

We’ve been going back and forth on whether to get new ironwork cast for the stoop or buy old stuff and restore it. Unfortunately we’ve put it off so long there isn’t time for new any more (the lead time is months, not weeks). So yesterday we went to Demolition Depot and got 11 balusters…

The ones with peeling yellow paint are an exact match to what was on our house. The brown ones are the same except in one little detail.

Turns out Demolition Depot also has a newel post that’s very similar to the ones originally on our house. This is what ours looked liked…

Our Stoop 1940We know from looking at our older, cousin townhouses on 127th, that ours probably had a finial at the top which was missing by 1940…

127th Street Newel Posts

Now compare those to what Demolition Depot has…

Not exactly the same, but very similar. Problem is, it’s not for sale – they’ll only rent it out for castings (@ $2,500/week!!!) Still, I’d LOVE to have a reproduction of something that’s even close to what was there originally – though we may just settle for masonry/stucco newel posts.

What we absolutely need to find are railings. We have most of one side, but the top of one side and all of the other side are missing. If anyone knows where we might find railing, please let me know – jay@beatingupwind.com

Lots Of Little Things Are Getting Done

The last week or so there have been a lot of little things getting done… It’s feeling more and more complete…

The railings are being installed for our staircase…

stair railings

All the steel will be painted white, and there will be milk white plexi panels mounted on those frames and wood handrails. The railings are a bit shaky because they’re so thin. We’re hoping the plexi and handrails will stiffen things up a bit.

One of my favorite features in the house is the laundry chute from the master bedroom into the laundry room.

laundry chute

It’s funny to find a hole in the floor exciting, but it’s pretty cool (as is the whole concept of a laundry room – I’ve never had in-unit laundry before).

And a bunch of electrical stuff has taken shape…

The lights are on the front of the building…

front lights

We’re not sure whether we like those lights or not – they were inexpensive – we’ll change them later if we decide we want something better.

The track lights are mostly in and the lights are being put on the tracks…

track lights

We like how minimal they are – the big part of the lens is just a little bigger than a quarter – so it’s pretty tiny.

And the smoke detectors have been installed, but the little protective plastic bags sorta defeat the whole point of detecting smoke…

smoke detectors

The thing I’m not looking forward to is that NYC code requires all the smoke detectors to go off when one of them goes off. When Dan burns something on the stove it’s going to be LOUD. But on the good side, they’re all hardwired – so no dead batteries to worry about.

And the last of the bathrooms has been tiled (the master bathroom)…

master bath tiled

That took one of the workers 3 weeks to tile… The guy is slow, but he’s an absolute perfectionist so it’s flawless when you look at it close up. The same guy is now skim coating some of the walls (like the walls in the bathroom above).

Hopefully in the next week some of the plumbing fixtures will start getting installed and there will be a big push on painting and finishing up the floors.

Today we went to Ikea to buy closets, but when we got there we hated them. They’re not nearly as well made as Ikea’s kitchens. The closet solutions at Container Store are about 50% more – so we’re not sure what we’ll do – maybe just have the contractor make what we originally planned.

Problems With DOB Continue

The insane bureaucracy at the Department of Buildings is causing us huge problems, AGAIN. Near the end of every job there are a host of little things that have to be corrected on the filed plans so when the final inspection happens, what the inspector sees matches what’s on the plans. The most critical issue in our case is that the sizing of the gas pipes wasn’t specified in the original plans, and the plumbing inspector won’t sign off on the work until they’re shown. Without his sign off we can’t get our “blue card” and without the blue card we can’t get gas service and without gas service we have no heat. Without heat we can’t really put water throughout the building for fear of frozen pipes. But pipe sizing is just one of many issues that need to be corrected on the plans – there’s a bunch of other stuff – none of which is major.

When we filed for a Post Approval Amendment (PAA) we were told our original plan examiner had been promoted – he’s now part of some centralized watch dog oversight group. The problem is the new plan examiner has to sign off on everything – not just the things that are changing. He found a pretty fundamental flaw with the original filing – the “construction classification”…

Construction Classification:
Existing: 3: NON-FIREPROOF STRUCTURES
Proposed: I-D: 1 HOUR PROTECTED

The problem is 1D with 1 hour fire protection isn’t what we’re doing – that would require all floors/ceilings and significant walls to have a 1 hour fire rating – the job should never have been filed that way. The plans clearly show that only certain parts of the building will have 1 hour fire rating – between the units, around the boiler room and the stairwell in our unit. The architect and expediter got it wrong, I didn’t notice it, and the original plan examiner missed it. But it makes a difference. Apparently construction classification is something FDNY relies on when they go to fight a fire. They don’t send fire fighters in after a certain amount of time unless they know the building will be safe.

The problem compounds itself since certain things that are allowed in fire rated construction aren’t allowed in non-fireproof buildings. For example closets and storage spaces under egress stairs aren’t allowed since a fire could start in the closet. So now we have to go back and pick the best/correct classification, and then see if there’s anything we’ve built that doesn’t comply with that classification. It’s fortunate at this point that we’re “fully sprinklered”, but my worry is that additional sprinkler heads might be required since “fully sprinklered” means different things depending on the situation. For example our power room on the parlor floor is under the stairs. Will it now need to be sprinklered?

The plan examiner made it clear that he wasn’t going to stop with the construction classification. Our appointment wasn’t as long as it needed to be and he had just started in on other items by the time it was over. He pointed to the stairs off the rear deck that go down into the garden and asked aloud if that they were a “permitted obstruction”. Because our rear yard is a couple feet below the level of the basement/ground floor the staircase from the rear deck goes (a couple feet) “more than one story” and that changes things. UGH… For god’s sake – it’s essentially one story – is it really that big of an issue? I’m thinking we may need to create a berm in the back yard that’s level with the basement/ground floor and have the stairs touch down at that point in the yard. IMHO, that’s just bureaucratic insanity, but we gotta do whatever it takes to get things done and signed off…

Unfortunately, you can’t get individual sheets approved. In our case we need the gas riser diagram approved, but all the other things are holding it up. On a larger project you’d file the plumbing as a separate job so you could do narrower PAAs, but that generally isn’t cost effective in project our size. If we could just get that one sheet signed off, things wouldn’t be so dire right now.

The bottom line when we left the plan exam was that, unless we do something drastic, it will probably take months of appointments to get the PAA approved. The new plan examiner is just going to keep finding one thing after another and draw out the process as long as possible – all things that have been signed off on in the past. We don’t have months to complete the project. We need gas, we need heat, and we need to move in so we can stop paying rent and storage fees on top of mortgage.

Our architect has worked on some really large, big budget projects and as a result knows expediters with decades of experience who have a much easier time getting things through DOB. We’re hiring one of those people to do code review and take over expediting. It’s going to cost us pretty big money, but delays and problems could potentially cost us even more. When we have our next plan exam, I’m hoping the plan examiner will know and trust our new expediter and when the plan examiner does bring up issues I hope our new expediter will show he knows the code as well or better than the plan examiner. And if competence and experience aren’t enough, after decades of working with DOB, I’m guessing the new plan examiner will be friends with enough senior people at DOB that the plan examiner will know that just being arbitrarily difficult could backfire on him.

I was thinking ConEd was worse than the DOB. Now I’m back to thinking DOB is worse. I’ll just be happy when things are signed off and we can move in.

Lighting Makes A Huge Difference

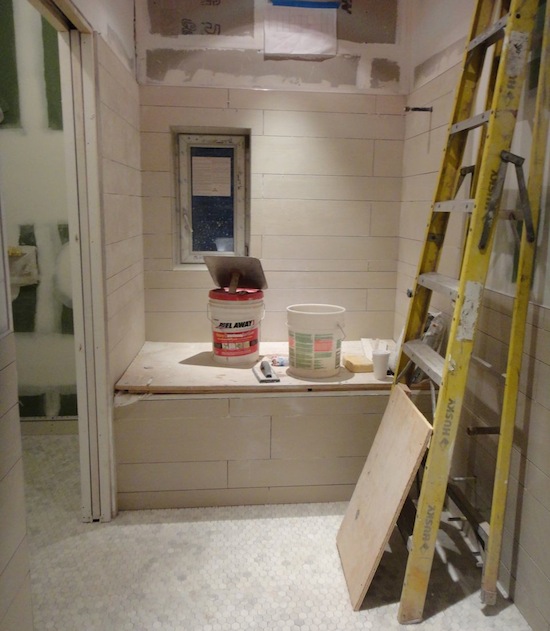

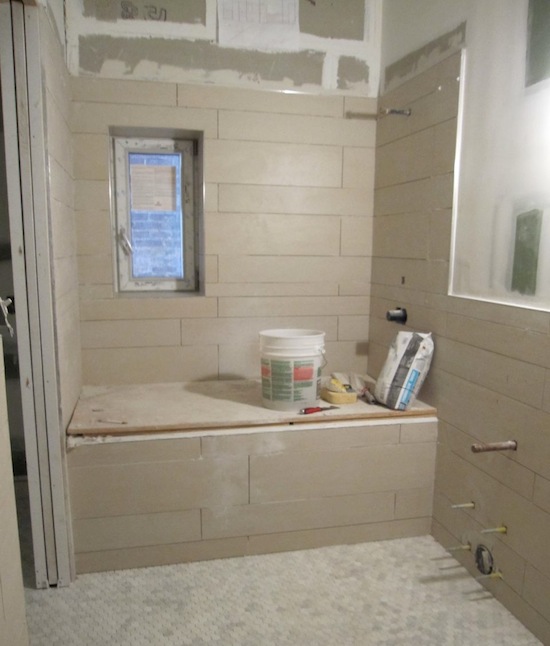

The Electrician’s guys were in today installing a few fixtures here and there. One place where they put in lights was in the bathroom and the effect was pretty dramatic. On the left is an incandescent bulb, on the right is recessed lights with MR-16s (I think).

nice bathroom lighting

(You can click on the images above to see larger versions.)

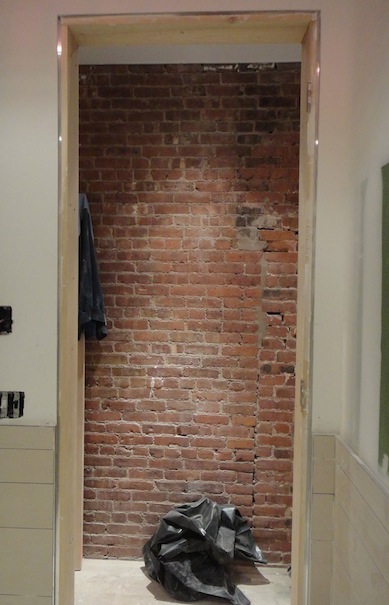

Here’s an image looking out of the bathroom into the hallway – the lighting makes the brick look pretty great as well…

nicely lit brick wallLooks like a great place to hang art :)
